If you are planning a solar energy storage system, there is a fundamental architectural decision you need to make before you even pick out a battery brand. It’s called coupling.
While it sounds technical, the coupling method you choose will influence your system’s performance for decades, making it one of the most important design considerations in solar energy storage. This architectural choice determines everything from your system’s efficiency and installation costs to its future expandability.
To help you make an informed decision, let’s break down the differences between DC and AC coupling, how they work, and which one is right for your energy goals.
The Basics: Speaking the Language of Electricity
To understand coupling, we first need to look at the “native languages” of your electrical components.
- DC (Direct Current): This is the native language of solar panels and batteries. Solar panels naturally produce DC electricity from sunlight, and batteries store energy in DC form.
- AC (Alternating Current): This is the language of the grid and your home appliances. In the US, for example, the electron flow reverses direction 60 times per second.
Inverters act as “translators,” converting DC electricity into AC so your home can use it. The difference between AC and DC coupling really comes down to when and how often this translation happens.

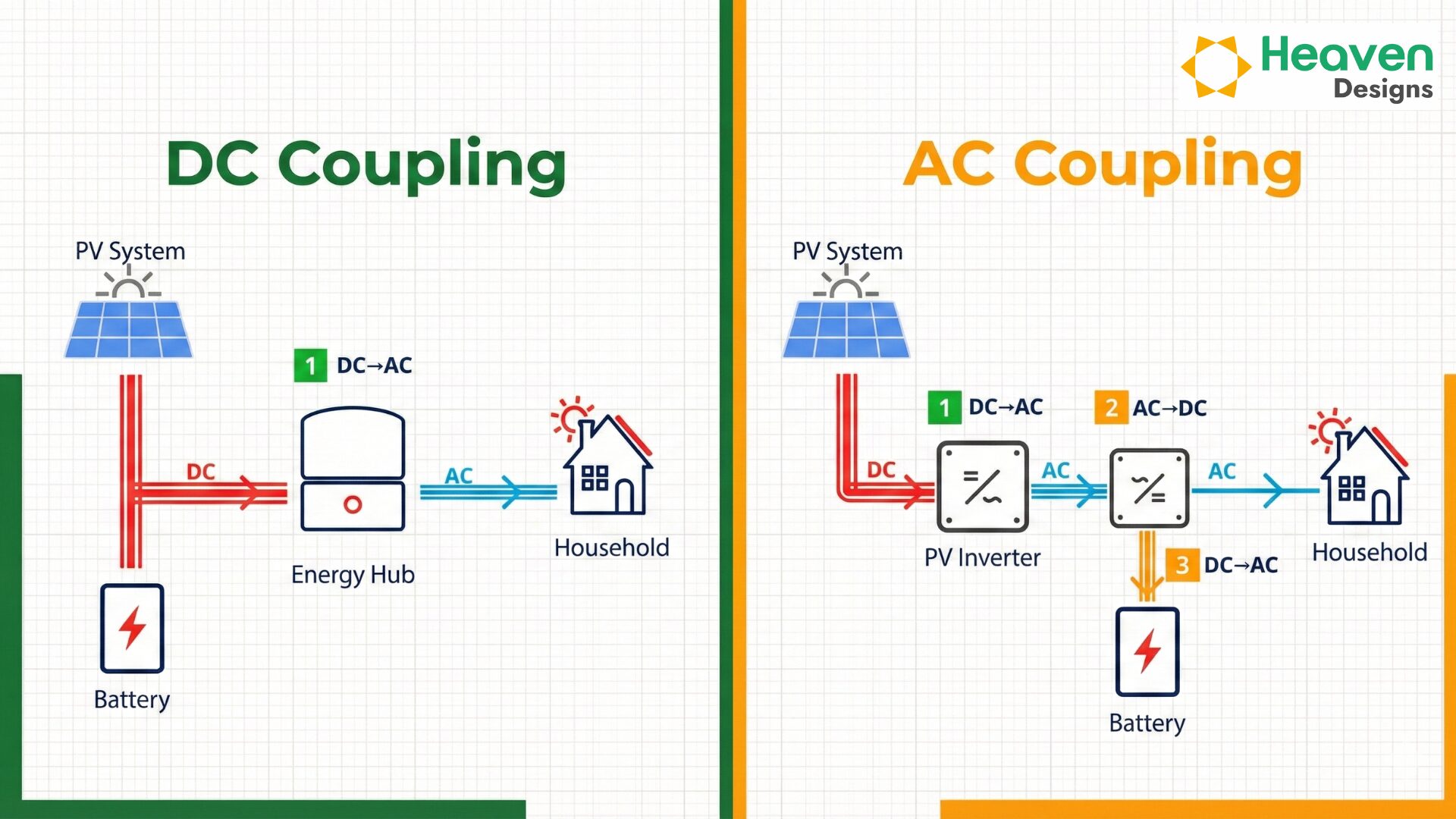

Option 1: DC Coupling – The Direct Route
DC coupling is considered the most direct and efficient pathway for solar energy storage. In this setup, the solar panels and the batteries share the same “brain”—usually a hybrid inverter or a shared charge controller.
How It Works
The process is streamlined. The energy flows from the panels to the battery in its native DC form, without being converted to AC first. The electricity undergoes only one single conversion from DC to AC when it is finally sent to power your home or the grid.
The Advantages
- Superior Efficiency: Because there is only one conversion step, DC-coupled systems typically achieve 4–8% higher round-trip efficiency compared to AC coupling. This means more of the solar energy you capture actually gets used.
- Faster Charging: The direct flow allows for faster battery charging, which is incredibly valuable during short winter days or variable weather.
- Simplicity for New Builds: If you are designing a system from scratch, this architecture offers fewer components and simplified wiring.
The Drawbacks
- Retrofitting is Hard: If you already have solar panels, switching to DC coupling usually means replacing your existing inverter, which can be costly.
- Upfront Cost: The hybrid inverters required for this setup generally cost more than standard inverters.
Option 2: AC Coupling – The Flexible Solution
AC coupling takes a completely different approach. It treats your solar generation and your battery storage as two independent subsystems that communicate using the common language of AC electricity.
How It Works
This architecture involves a “translation” relay. The DC energy from the panels is converted to AC by a solar inverter. If that energy needs to be stored, a separate battery inverter converts it back to DC to put it into the battery. When you need to use that stored energy, it is converted back again to AC .
This results in a cycle of multiple conversions (DC → AC → DC → AC).
The Advantages
- Seamless Retrofits: This is the primary strength of AC coupling. You can add batteries to any existing solar installation without touching the original inverter or warranty.
- Vendor Independence: You aren’t locked into one brand. AC coupling works with virtually any combination of solar inverters and battery systems.
- Easy Expansion: If you want to add more batteries or solar capacity later, you can do so independently without redesigning the whole system.
The Drawbacks
- Efficiency Loss: Those multiple conversions add up. You can expect cumulative efficiency losses of 8–12% compared to DC coupling. Over 25 years, this can represent thousands of dollars in lost production.
- Battery Stress: The repeated conversions and frequent cycling can generate heat and electrical stress, potentially reducing battery lifespan by 5–10%.
Which One Should You Choose?
The decision isn’t just about technical specs; it is about matching the architecture to your specific situation. Here is a quick guide:
Choose DC Coupling if:
- You are installing a brand new system. For new installations, the efficiency and streamlined design of DC coupling make it the optimal choice.
- You are off-grid. The simplified architecture is especially advantageous for remote installations or areas with unreliable grid connections.
Choose AC Coupling if:
- You already have solar panels. AC coupling dominates the retrofit market because it preserves your current investment and allows you to add storage easily.
- You want maximum equipment choice. If you want to mix and match vendors or prioritize future flexibility, AC coupling is the standard.
Conclusion
Ultimately, there is no single “best” method. DC coupling offers superior efficiency and is perfect for new projects, while AC coupling offers unmatched flexibility for upgrades. The right choice depends on your budget, existing equipment, and long-term energy goals.
